Product Details

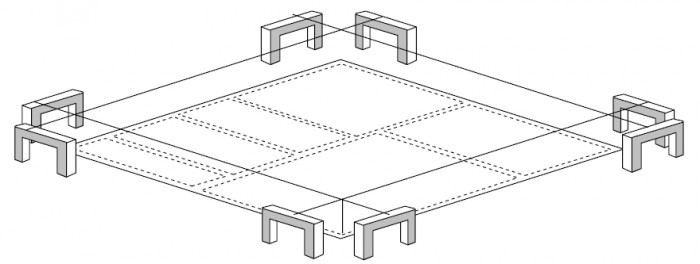

1. AFTER CLEARING AND LEVELING OF THE PLATFORM, THE POSITIONS OF THE EXTERNAL AND INTERNAL WALLS ARE SET-OUT

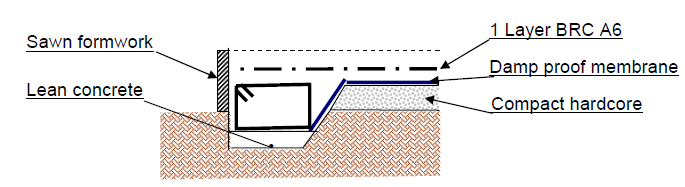

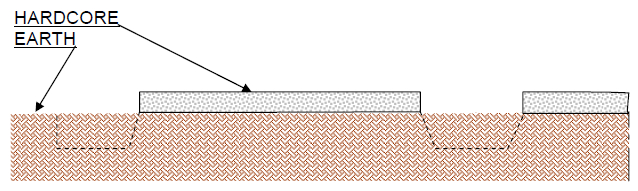

2.  A 100 MM THICK CONSOLIDATED HARDCORE BED IS LAID BETWEEN THE STRIP FOOTING MARKS.

3. THE STRIP FOOTING IS EXCAVATED

4. INSTALL UNDERGROUND PIPING AND DAMP PROOF MEMBRANE OVER THE HARDCORE BED.

5. POUR LEAN CONCRETE (GRADE 10) IN STRIP FOOTING, INSTALL SAWN FORMWORK AROUND THE CONCRETE FLOOR AREA AND
INSTALL RE-ENFORCEMENT STEEL AND BRC-LAYER.

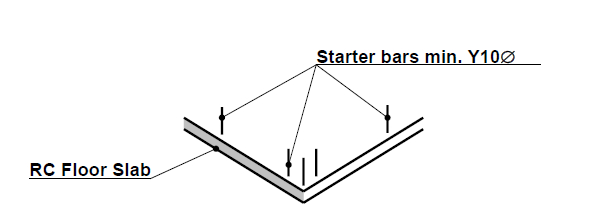

6. STARTER BARS ARE PLACED AT EACH POINT IN THE FLOOR WHERE
AN RC COLUMN OR STIFFENER WILL CONNECT TO IT.
CONCRETE (GRADE 20) IS POORED TO FORM THE RC FLOOR SLAB.

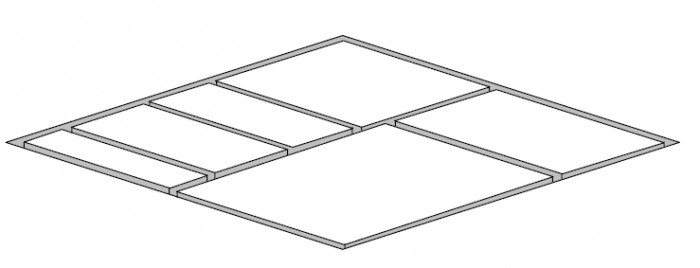

7. SETTING OUT AND INSTALLING FORMWORK (SINGLE FLAT FACE,
HAVING A WIDTH OF WHICH IS 200 MM WIDER THAN THE WIDTH OF
THE STIFFENER IT WILL FORM).
THE FORMWORK IS ERECTED AND BRACED IN THE CORRECT
POSITION ON THE RC FLOOR SLAB AT INTERVALS TO SUIT THE
LENGTH OF THE WWCB PANELS.
WWCB IS STACKED HORIZONTALLY AGAINST THE FORMWORK
(A GAP OF 75 MM IS MAINTAINED BETWEEN THE ENDS OF EACH
PANEL).

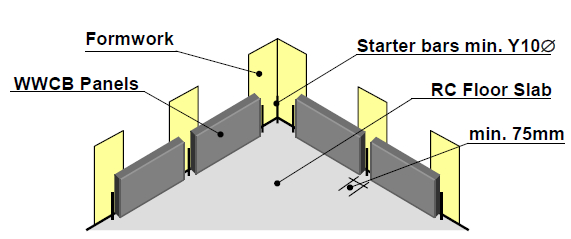

8. STACK THE WWCB UP TO RING BEAM HEIGHT AND INSTALL THE REINFORCING STEEL, TIED TO THE STARTER BARS. THE VOIDS ARE CLOSED WITH FORMWORK WHICH IS TIED THROUGH THE WWCB TO THE FORMWORK ON THE OPPOSITE SIDE AND THE VOIDS ARE FILLED WITH CONCRETE (GRADE 20) .

9. AFTER CURING, THE FORMWORK FOR THE RING BEAM IS INSTALLED, THE REINFORMENT STEEL PLACED AND TIED AND THE CONCRETE (GRADE 20) POURED.

Note: Every joinery opening i.e. doors and windows lined with a 75mm x 75mm stiffening element.

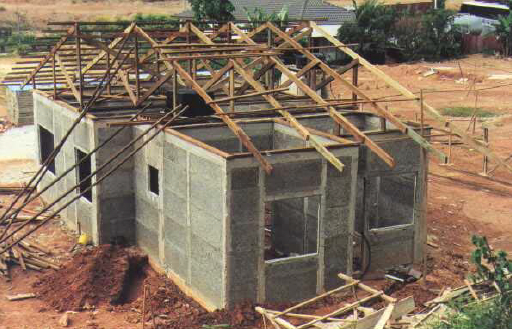

10. THE ROOF (WOODEN OR metaL frame) IS INSTALLED ONTO THE WALL PLATE.
QQ截图20140606150513

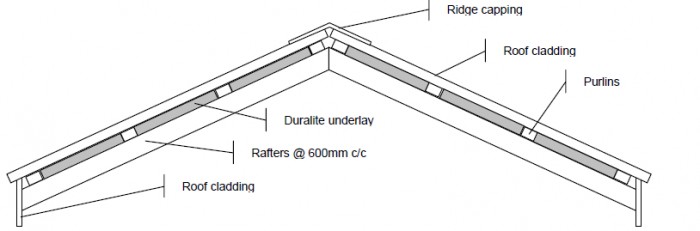

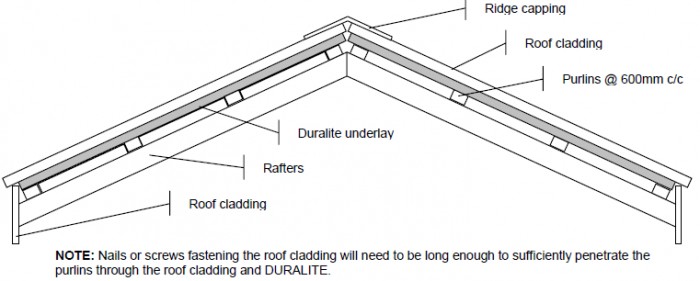

11. INSTALLING DURALITE AS ROOFING UNDERLAY METHOD 1: It is of primary importance when installing DURALITE as roofing underlay that provision is made for adequate support. For this purpose DURALITE is normally laid out on purlins that spaced not more than 23 5/8”(600mm) center to center. The roof cladding will be fixed the DURALITE to the purlins. Sizalation can be laid out over the DURALITE.
QQ截图20140606150513
METHOD 2: DURALITE could be laid between the purlins and the rafters would be spaced at a maximum of 23 5/8” (600mm) center to center. In this instance the
purlins would need to be at least of the same thickness of the DURARITE or thicker.
QQ截图20140606150513
12. THE PIPING FOR WATER AND ELECTRICITY IS INSTALLED AND
THE WALLS ARE PLASTERED WITH ONE 12MM THICK PLASTER
LAYER.
QQ截图20140606150513

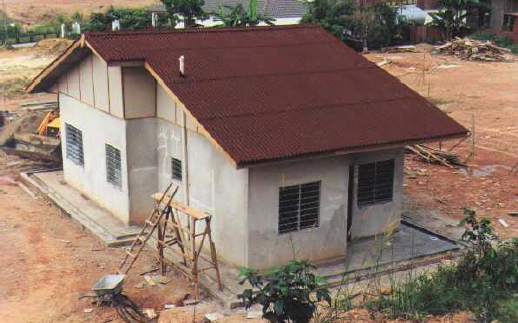

13. AFTER THE PLASTER IS SUFFICIENTLY DRY THE HOUSE CAN BE PAINTED, AND ITS COMPLETE.
QQ截图20140606150513
